    A9) Service BOM Update on Service Shipment

    This section focuses strictly on how the Service BOM is finalized when the repaired item is shipped. Shipment cost / billing mechanics were covered in step A8 and are not repeated here.

    The purpose of this section is to translate the approved repair scope (Construction → Production) into an authoritative Service BOM state that reflects:

    • Which components were physically replaced (historical trace)
    • Which components were newly installed (additions)
    • Which existing components were internally repaired (remain but flagged accordingly)
    • Updated attributes that now define the repaired configuration

    Preconditions (recap, no rework done here)

    • Final Construction Order (execution repair) was created from the main Service Line (Spare Part Action (DM) = Component Repaired).
    • Production Order finished (output = Repair Item with suffix, e.g. -REP).
    • Service Line for the repair output exists (Spare Part Action (DM) = Production Order).

    Trigger

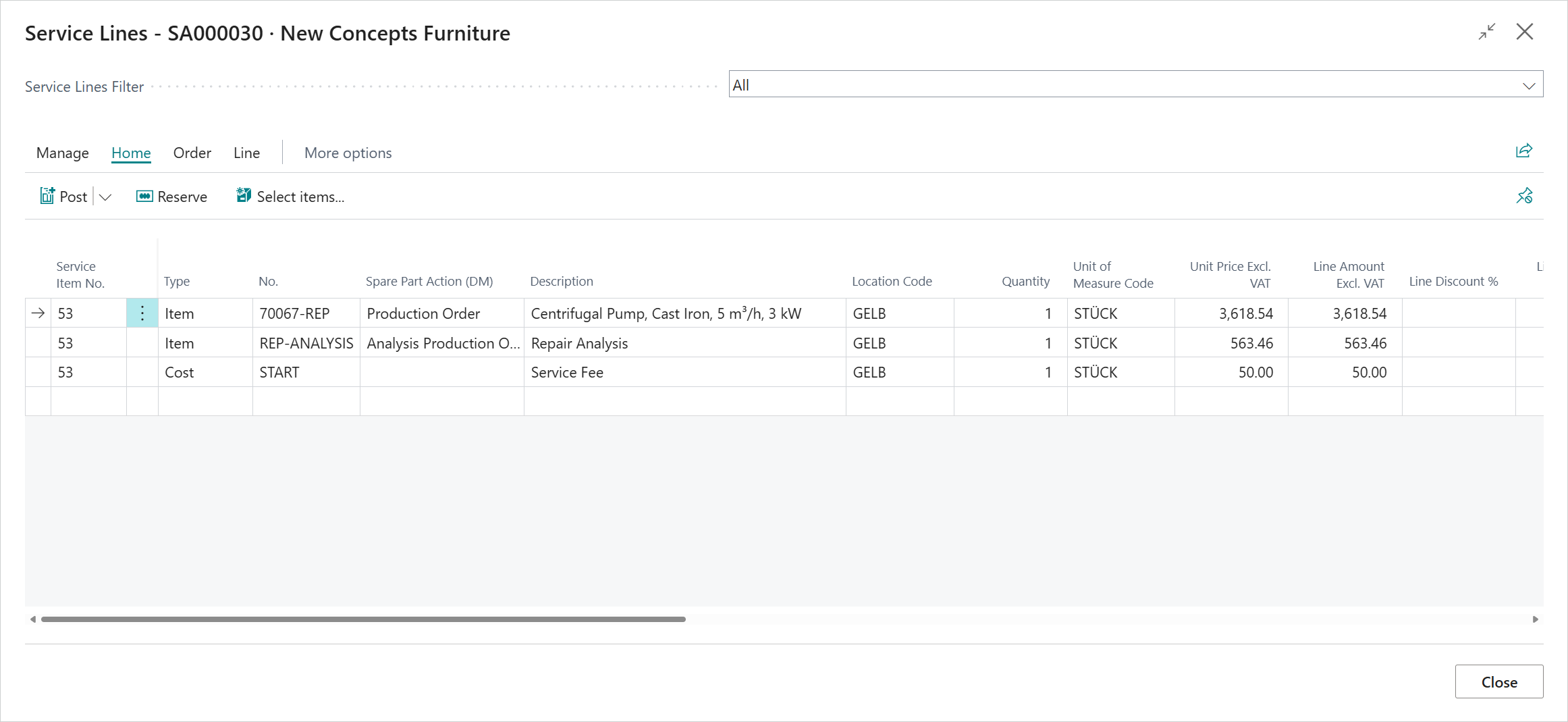

    Posting the Service Shipment for the Repair Output Service Line (Spare Part Action (DM) = Production Order). en-us/media/DM-service-quotation-service-line-shipment.png

    Line Evaluation Logic

    Each (execution) Construction Line transferred from the final Construction Order is interpreted by the Spare Part Action (DM):

    Spare Part Action (DM) BOM Effect Replaced Flag in Service BOM Structural Meaning
    Component Replaced Existing component logically retired, new one recorded Yes Substitution (old → new)
    Component Installed Added without retiring predecessor No Net addition (expansion)
    Component Repaired Same component retained (tracked as serviced) Yes Refurbished / restored

    Additional notes:

    • Analysis / Analysis Production Order lines never affect the Service BOM.
    • Pure G/L / cost / surcharge lines do not participate.
    • Resource lines (labor) are not written to the Service BOM (they only affect cost), unless custom extensions inject them.

    Resulting BOM State

    • The active Service BOM after shipment represents the post‑repair "as-maintained" structure.
    • Replaced = Yes lines allow downstream analytics (failure pattern, replacement frequency).
    • Newly installed parts (Installed) are distinguishable from substituted ones (Replaced).

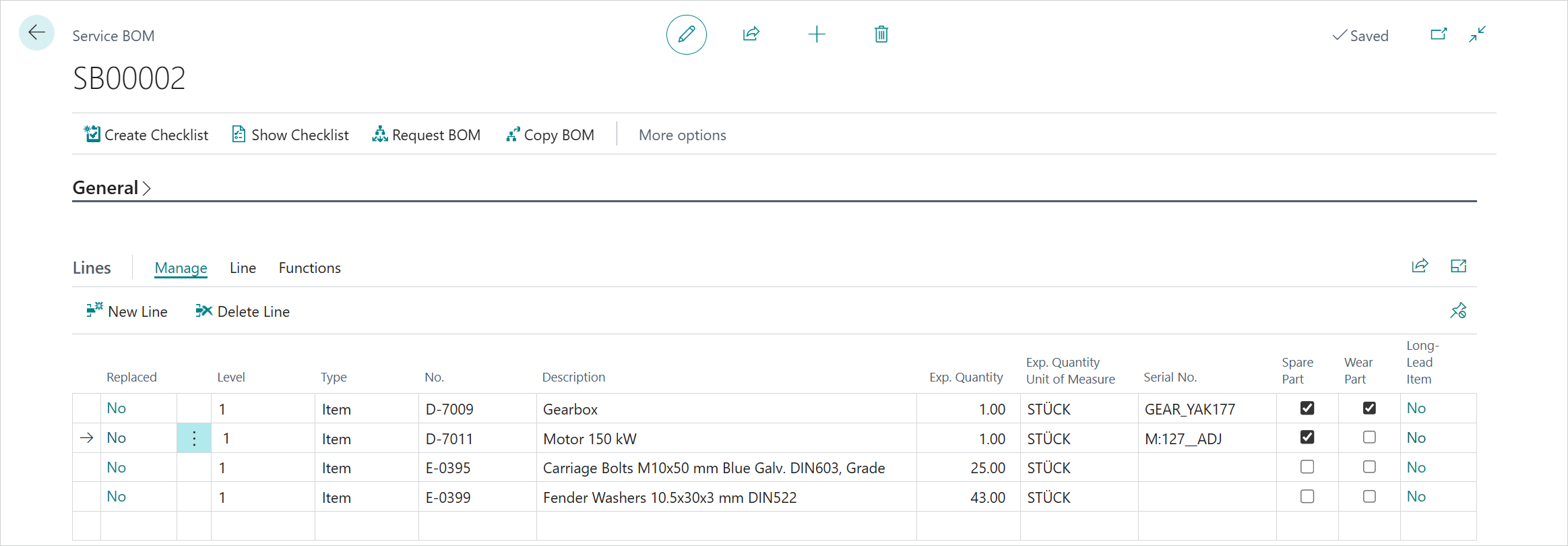

    • Repaired components (Component Repaired) keep continuity of identity while still flagged for service history. en-us/media/DM-service-quotation-service-bom-after-shipment.png

    Attribute Resolution Sequence

    When Service Shipment posts and (if needed) updates or inserts BOM lines, attributes are assigned in this precedence:

    1. Construction Line Attributes (if present)
    2. Existing Active Service BOM (for unchanged retained components)
    3. Item / Item Variant (master data defaults)

    Rationale:

    • Construction captures the most specific "as-built" snapshot.
    • Active BOM ensures continuity if no override was defined.
    • Item master fills gaps for newly introduced components without explicit construction attributes.

    Audit / Traceability

    Key trace points:

    • Service Shipment No. (document link)
    • Construction Order No. (origin of transferred scope)
    • Production Order No. (cost and output source)
    • Replaced flag and posting date (component life event)
    • Item Ledger / Value Entries (cost trail aligning later via Adjust Cost)

    Do not delete / recreate the Service Shipment to "redo" BOM effects; instead record corrective follow-up (e.g., supplemental repair) through an additional controlled service process.

    Edge Cases

    • Analysis-only outcome (no execution Construction Order): Service BOM is not touched.
    • Late discovery before shipment: add/adjust Service Lines, (if structural) re-run a controlled supplemental Construction step before shipping.
    • Wrong Spare Part Action (DM) chosen: correct the Service Line (pre‑shipment), re‑create Construction scope if needed; avoid shipping with incorrect action to prevent historical pollution.
    • Multiple sequential repairs: Each shipment commits a new BOM state; external reporting can diff consecutive snapshots.

    Outcome Summary

    • Service BOM now authoritative "as-maintained" structure.
    • Repair Output Service Line posted (basis for invoicing already described in A8).
    • Historical component transition (replace / install / repair) fully captured for lifecycle analytics.
    Tip

    Run the Adjust Cost - Item Entries batch job after shipment (timing per policy) so the Service BOM's cost-facing analytics align with finalized production valuations.
