Graphical Resource Planning
The Graphical Resource Planning page uses color coding to show project planners the resource availability for planned project lines based on Starting and Ending Dates defined in the Project Card. It also shows unplanned processes.
The Graphical Resource Planning page can be accessed in the following ways:
- To show resource planning for all projects, use Tell Me. Choose the
icon, enter Graphical Resource Planning, and then choose the related link. This view can also be accessed from the Role Center by choosing Graphical Planning > Graphical Resource Planning from the Planning action menu. - To show resource planning information for all projects assigned as My Projects in the Role Center, choose Graphical Planning > Graphical Resource Planning - My Projects from the Planning action menu or Project Resource Planning - My Projects from the My Projects drop-down arrow.
- To show resource planning information per project, open the Project Card. On the Navigate menu, choose the Graphical Resource Planning action.
- To show resource planning information for planning processes for the project, open the Project Planning and Processing page. On the Process Planning menu, choose Graphical Resource Planning.
- To show resource planning information for planning processes of a planning line, open the Planning Processes page (from the Project Planning and Processing page), and then choose Graphical Extension > Graphical Resource Planning on the Related menu.
The Graphical Resource Planning page can also be opened from the Graphical Project Planning page via the context menus and Graphical Resource Planning by Team page via the context menus.

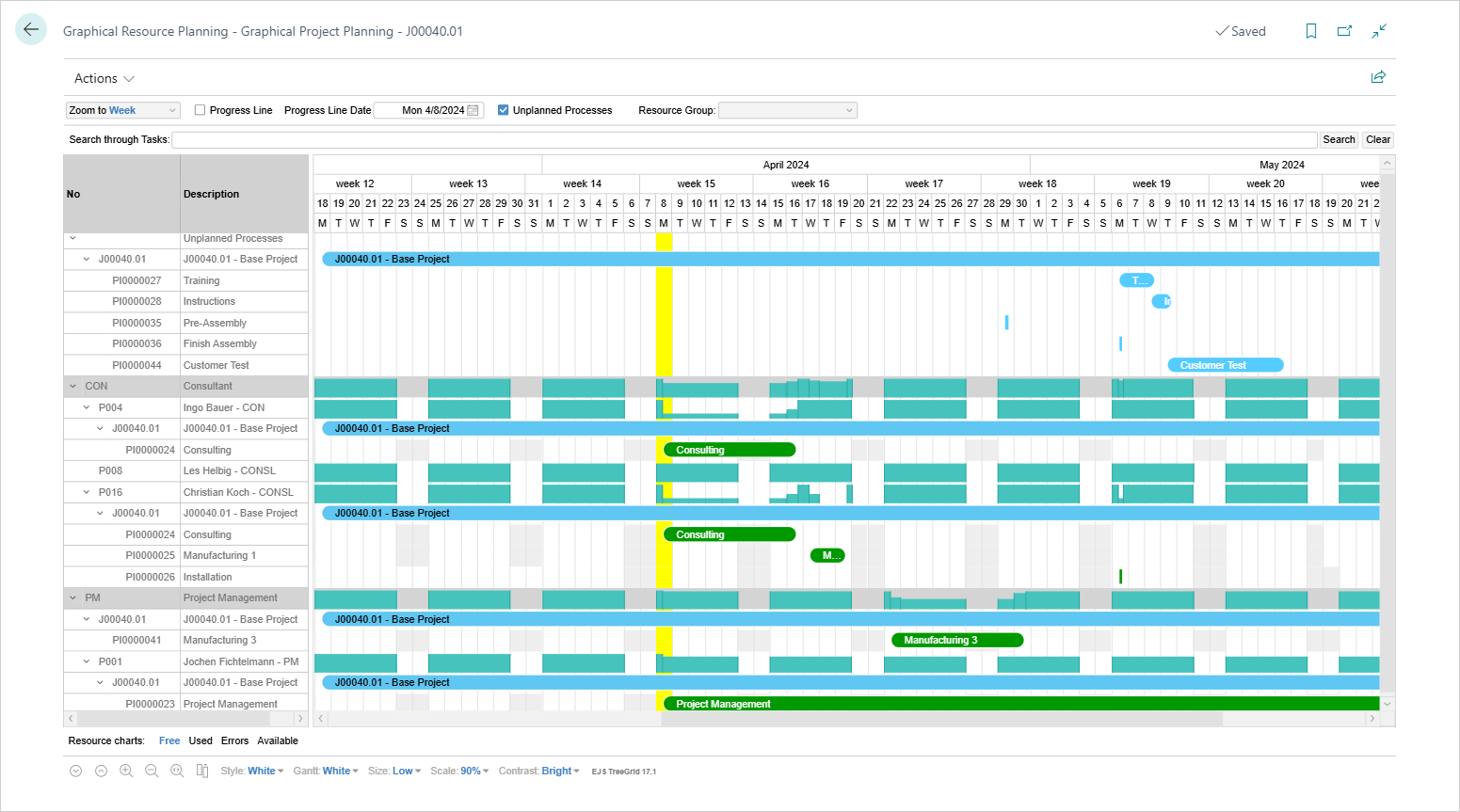

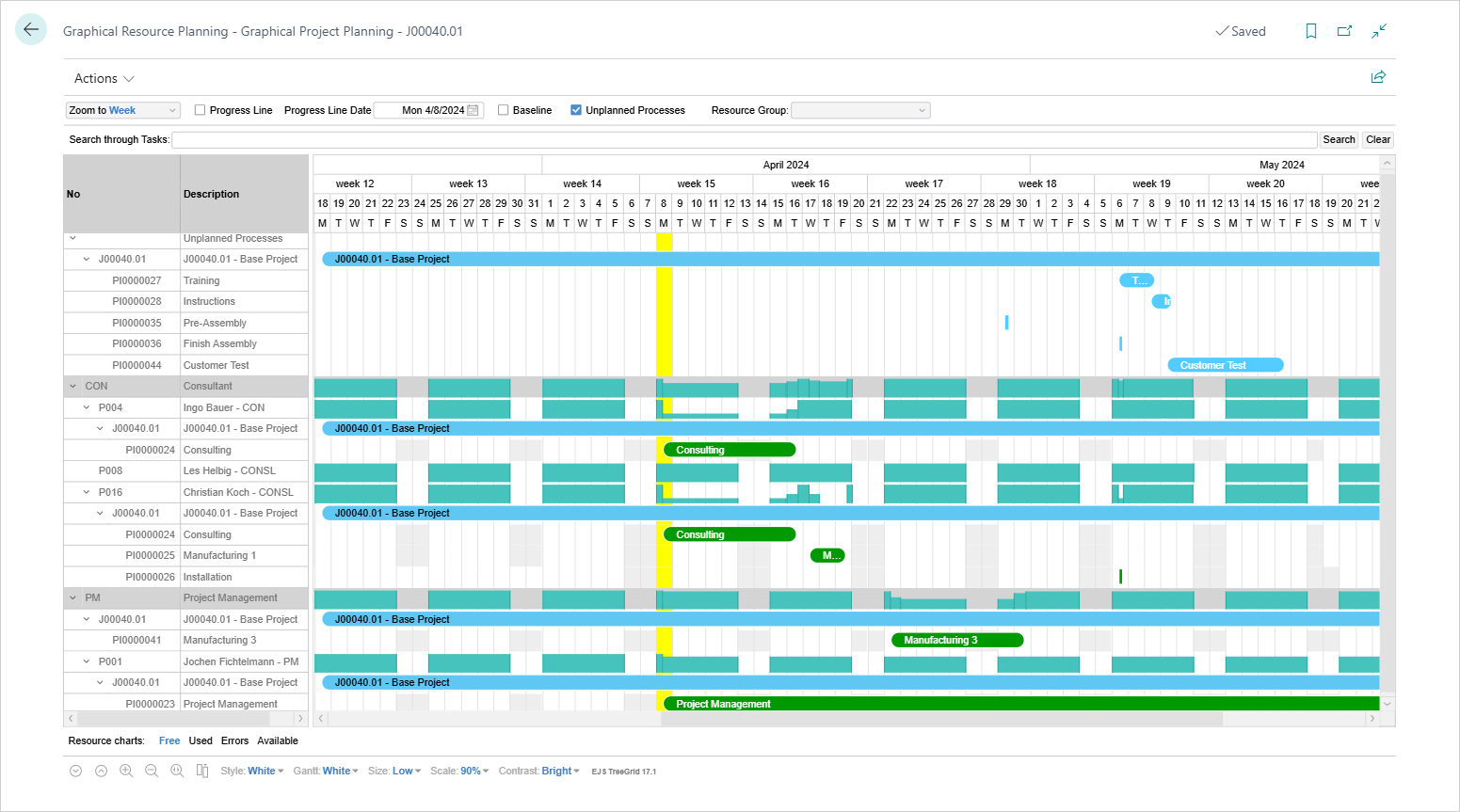

The following graphic shows processing lines with different colors for project lines (in blue) unassigned lines (in blue) and assigned lines (in green), as well as the work date highlight (in yellow) and resource availability (in teal).

Chart Layout
The left pane first shows any unplanned processes (project and related process planned project lines) and then is grouped by resource group, resource, project, and related process planned project lines. The right pane shows the timeline of the availability or over-planning with color coding.
Availability
The availability is visible on the resource group and resource lines in the right pane. Depending on setup, the colors can be different. But if default settings are used, the chart shows:
- available time in teal (above the baseline)
- over-planned resources in red (below the baseline)
- not available or not over-planned shows neither (empty space)
Progress Completion Indicators
The % Complete from the planning processes is visualized in the project lines in two ways:
- Show the Progress column (only visible when manually shown via the Displays menu to choose visible columns icon below the chart)
- Color variation in the lines in which the darker color is the completed percentage (always visible)
The progress completion can be changed manually in the Progress column, which automatically updates the color variation in the lines.

Progress Line

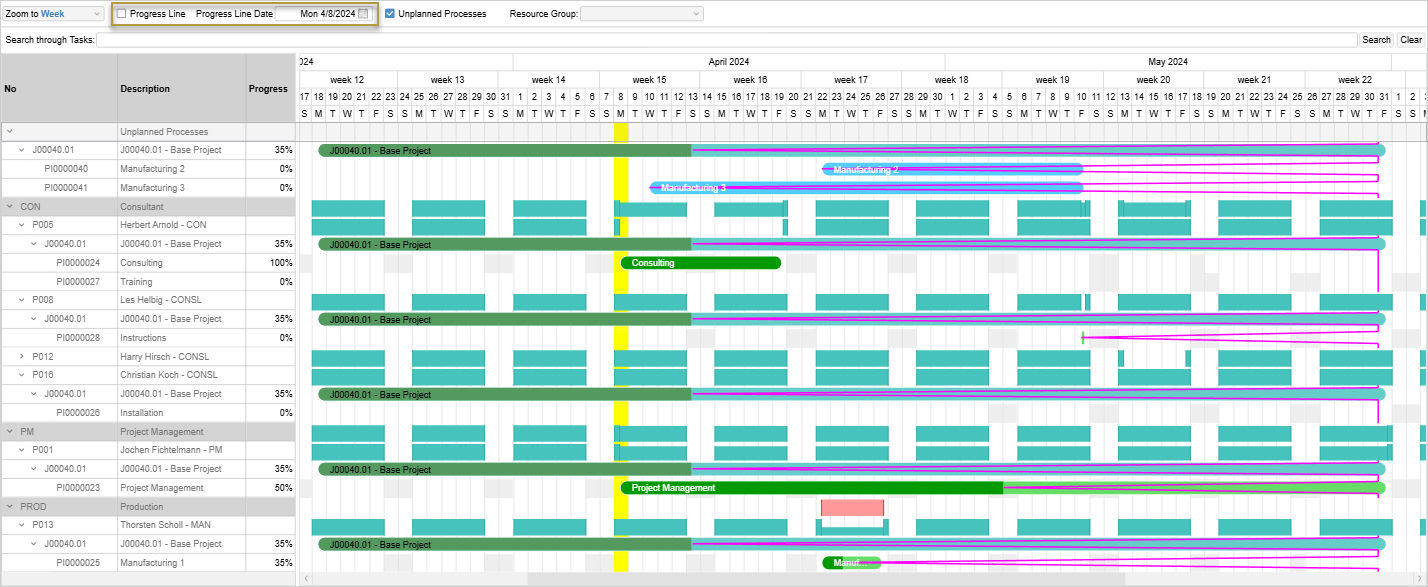

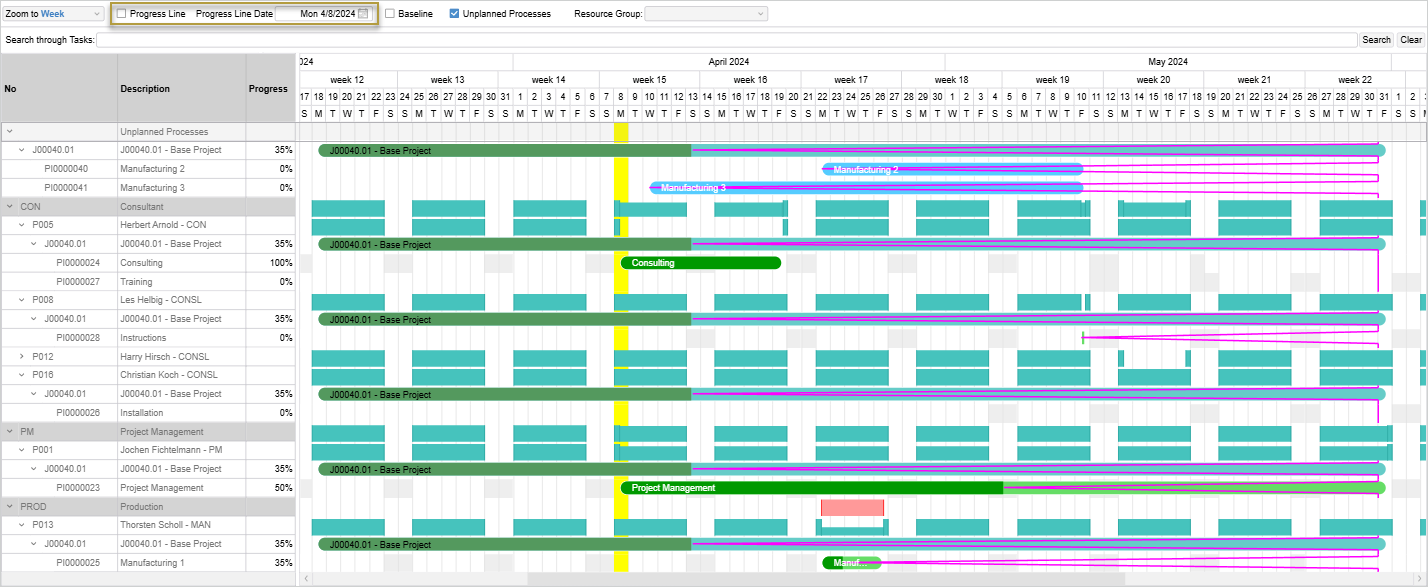

Setting an end date in the Progress Line Date field and then selecting the Progress Line checkbox adds the Gantt progress line to the view.
- If the planning lines start before the Progress Line Date, then the progress line starts either at the start of or at the end of the completion percentage in the planning lines and ends at the specified end date.
- If the planning lines start after the Progress Line Date, then a vertical line is shown at the specified date, with no progress.
Lines with completed planning show no progress lines.

Resource Charts
Below the chart are the Resource charts options, which determine what availability information is shown in the chart. Each is described below:
- Free – No filtering, all availability usage is displayed.
- Used – Shows only the times in which resources are not available for planning.
- Errors – Shows only the resources that have been over-planned.
- Available – Shows only the times in which resources are available for planning.
Context Menus
On both sides of the chart, context menus can be opened to provide additional information about the resource group, resource, project, or process planning line. Tap and hold (or right-click) the line to open the context menu.
For detailed information about these menu items, see Capacity and Resource Planning.
For the resource groups:
- The Resource Group Card menu item opens the related Resource Group Card.
- The Planning Resource Group Card menu item opens the Planning Resource Card for the resource group.
- The Graphical Project Planning menu item opens the Graphical Project Planning view view that displays all projects and process lines assigned to the resource group within the time period.
- The Schedule Entries menu item opens the Project Schedule Entries page filtered on all schedule entries for the resource group within the time period.
For the resources:
- The Planning Resource Card menu item opens the Planning Resource Card for the individual resource.
- The Resource Card menu item opens the related Resource Card.
- The Schedule Entries menu item opens the Project Schedule Entries page filtered on all schedule entries for the resource within the time period.
- The Graphical Project Planning menu item opens the Graphical Project Planning view that displays only the planning assigned to that resource, for any projects the resource belongs to, within the time period.
For the projects:
- The Project Card menu item opens the related Project Card.
- The Project Team menu item opens the related Project Team page.
- The Project Planning Setup menu item opens the Project Planning Setup page.
- The Project Planning and Processing menu item opens the Project Planning and Processing page that focuses on all operative processes for planning, purchasing, and project delivery.
- The Project Procurement Block View menu item opens the Project Processing Procurement page that shows the block view of procurement processes for the selected project.
For the project planning lines with unplanned processes:
- The Project Card menu item opens the Project Card of the project corresponding to the selected project planning line.
- The Process Card menu item opens the Project Process Card that provides a card view of all the information in the Project Planning and Processing page for the selected project planning line.
- The Process Planning Block View menu item opens the Planning Processes page that shows the block view of unplanned processes for the selected project planning line.
- The Procurement Block View menu item opens the Project Processing Procurement page that shows the block view of procurement processes for the selected unplanned process line.
- The Graphical Resource Planning menu item reopens the Graphical Resource Planning view focused to the selected unplanned process line. The selected unplanned process line is shown in orange in the right pane and shaded in the left pane to mark which process line opened the Graphical Resource Planning page. The shading on the left pane will differ depending on style/gantt settings.
- The Graphical Resource Planning by Team menu item opens the Graphical Resource Planning by Team view focused to the selected unplanned process line. The selected unplanned process line is shown in orange in the right pane and shaded in the left pane to mark which process line opened the Graphical Resource Planning page. The shading on the left pane will differ depending on style/gantt settings.
For the project planning lines with planned processes:
- The Project Card menu item opens the Project Card of the project corresponding to the selected project planning line.
- The Process Card menu item opens the Project Process Card that provides a card view of all the information in the Project Planning and Processing page for the selected project planning line.
- The Assigned Resources menu item opens the Project Processes page that shows all resources assigned to the planning line.
- The Process Planning Block View menu item opens the Planning Processes page that shows the block view of planned processes for the selected project planning line.
- The Procurement Block View menu item opens the Project Processing Procurement page that shows the block view of procurement processes for the selected planned process line.
- The Schedule Entries menu item opens the Project Schedule Entries page that shows the scheduled project planning lines for the selected project planning line.
Tooltips
The right-pane includes tooltips for the project and process lines:
- Project line tooltips show the related project number, status, project description, start/end date/time, and completion percent of the process line.
- Unplanned process line tooltips show the related project number, status, process description, process number, start/end date/time, completion percent of the process line, and duration (e.g., 2 Weeks).
- Process line tooltips show the related project number, status, start/end date/time, completion percent of the process line, and the assigned resource(s).
To view a tooltip, tap (or hover over) an entry.
While moving unplannned or planned process lines, a tooltip shows the new dates of the potential change.
Usage
The Graphical Resource Planning page provides a wide-range of information about resource planning. It can be used as a general overview but also helps you focus attention on potential problems in your resource planning activities.
Additionally, you can assign resources to unplanned lines or move resources to different lines to prevent over-planning.
Unplanned Processes
Unplanned processes are shown at the top of the chart layout. Expanding this shows the processes that have yet to be assigned to a resource.
Note
The resource must be part of the Project Team in order to move a process to the resource.
To adjust unplanned process lines
Prior to assigning processes to a resource, adjustments can be made to the unplanned process lines.
- To move a start or finish date of an unplanned process line, tap and hold (or click) the start or end of the line and extend or shorten the time frame.
- Duration Quantity, Duration Format, Work Quantity, Work Format, and Planned Capacity % of the planning processes are updated in the Graphical Resource Planning page based on the standard COSMO Project Manufacturing calculations, which considers the time frame and capacity changes.
- If the start or finish date of an unplanned process line is extended/shortened in the right pane, and the Process Type Fixed field is:
- Work, then the Planned Capacity %, Duration Quantity, and Start and/or Finish dates are changed in the process line as well as in the left pane (if shown via the Displays menu to choose visible columns icon).
- Duration, then the Work Quantity and Duration Quantity are changed in the process line as well as in the left pane (if shown via the Displays menu to choose visible columns icon).
- To adjust unplanned process lines using the Work Quantity, Work Format, Duration Quantity, Duration Format, Process Type Fixed, and Planned Capacity columns, add the columns via the Displays menu to choose visible columns icon at the bottom of the chart.
- Changes made in the Work Quantity column will extend/shorten the time frame in the right pane as well as update the Duration Quantity and other relevant parameters in the process line if the Process Type Fixed field is Work. If the Process Type Fixed field is Duration, the Planned Capacity % is changed.
- Changes made in the Duration Quantity column will extend/shorten the time frame in the right pane as well as update the Planned Capacity % and other relevant parameters in the process line if the Process Type Fixed field is Work. If the Process Type Fixed field is Duration, the Work Quantity is changed.
- Changes made in the Planned Capacity column will extend/shorten the time frame in the right pane as well as update the Duration Quantity and other relevant parameters in the process line if the Process Type Fixed field is Work. If the Process Type Fixed field is Duration, the Work Quantity is changed.
- Changes made to the format (hours, days, etc.) can be done directly in the Work Format and Duration Format columns to update the planning line.
To assign a process to a resource
- In the left pane, tap and hold (or click) an unplanned process line.
- Drag and drop the line to a resource/resource group.
- Adjust the timing as needed.
- Adjust the assigned hours/capacity for the resource/resource group by choosing Assigned Resources on the content menu the process lines, as needed.
Planned Processes
The planned processes are assigned to the resources within the resource groups. If there is a over-planning for a resource, you can move the planning line to another time, another resource, or copy it to another resource to split the time.
To move planning to another time
You can either move the complete line to another time or you can extend or shorten the time frame.
- To move an entire line to another date, tap and hold (or click) the process line then and move it forward or backward to the new date.
- To move a start or end date of a process line, tap and hold (or click) the front or end of the line and extend or shorten the time frame.
To move planning to another resource
Moving allows you reassign a planning to a different resource/resource group.
- In the left pane, tap and hold (or click) the process line.
- Drag and drop the process line to the new resource/resource group.
- In the dialog cox, choose the Move option and then choose the OK button.
- Adjust the timing as needed.
To copy planning to another resource
Copying allows you assign a planning to multiple resources.
- In the left pane, tap and hold (or click) the process line.
- Drag and drop the process line to the new resource.
- In the dialog cox, choose the Copy option and then choose the OK button.
- Adjust the timing as needed.
- Adjust the assigned hours/capacity for the resources by choosing Assigned Resources on the content menu of one of the process lines, as needed.
Feedback
