Graphical Project Planning
The Graphical Project Planning page uses color coding to show project planners start and end dates for planned project lines, as well as any dependencies between them.
The Graphical Project Planning page can be accessed in the following ways:
- To show planning information for all projects, use Tell Me. Choose the
icon, enter Graphical Project Planning, and then choose the related link. This view can also be accessed from the Role Center by choosing Graphical Planning > Graphical Project Planning from the Planning action menu. - To show project planning information for all projects assigned as My Projects in the Role Center, choose Graphical Planning > Graphical Project Planning - My Projects from the Planning action menu or Project Planning - My Projects from the My Projects drop-down arrow.
- To show project planning information per project, open the Project Card. On the Navigate menu, choose the Graphical Project Planning action.
- To show project planning information for planning processes for the project, open the Project Planning and Processing page. On the Process Planning menu, choose Graphical Project Planning.
- To show project planning information for planning processes of a planning line, open the Planning Processes page (from the Project Planning and Processing page), and then choose Graphical Extension > Graphical Project Planning on the Related menu.
The Graphical Project Planning page can also be opened from the Graphical Resource Planning page via the context menus and Graphical Resource Planning by Team page via the context menus.
The following graphic shows processing lines with different colors for main project line (in gray), summary lines (in purple), process lines (in blue), project schedule line (above process lines in orange), lead time process lines (in black), and the work date highlight (in yellow). The extra shading in the first two process lines indicate progress completion.

Note
The Starting Date and Ending Date fields must be defined in the Project Card for the project to be included in the Graphical Project Planning page.
Additionally, if the Graphical Project Planning page is opened from the Project Card, and parameters (such as start/end date or project status) set in the Graphical Project Planning Setup page do not match the related project settings, then a message will inform the user that the project falls outside of these parameters and the data cache needs to be updated.
- Choosing the Yes button will update the parameters in the Graphical Project Planning Setup page and, therefore, the project will be shown in the Graphical Project Planning page.
- Choosing the No button will disregard the data cache update and the project will not be shown in the Graphical Project Planning page.
Chart Layout
The left pane shows the project and related process planning lines or project schedule entries. The right pane shows the corresponding project line processes as well as any dependencies between the project lines.
Note
If no resource planned hours or scheduled hours have been processed, then the Start and Finish dates in the Planning Process page are used in the right pane.
In the Zoom to ... drop-down, choose the relevant period to better see milestones at the top.
Summary Process Lines
You can distinguish between summary planning process lines and regular planning process lines by choosing different colors in the Summary Project Line Color and Project Line Process Color fields in the Graphical Project Planning Setup page.
Summary process lines are shown based on the Summary Start and Summary Finish fields in the Planning Processes page and cannot be changed.

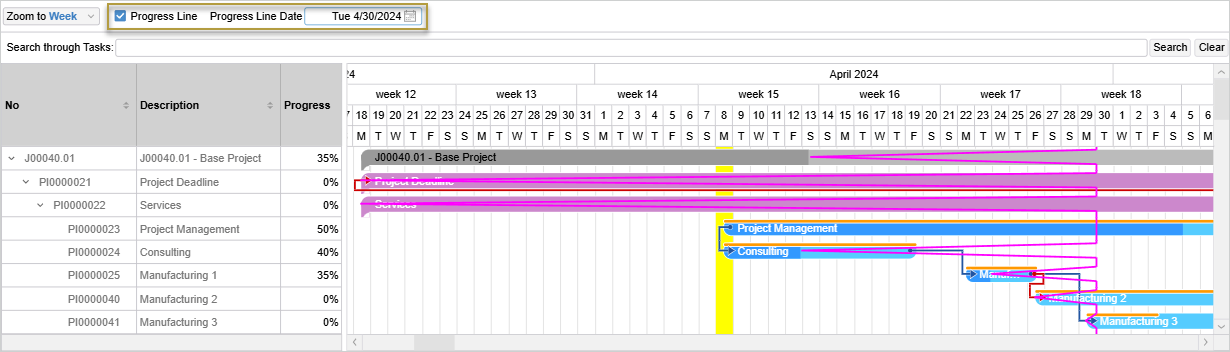

Progress Line
Setting an end date in the Progress Line Date field and then selecting the Progress Line checkbox adds the Gantt progress line to the view.
- If the planning lines start before the Progress Line Date, then the progress line starts either at the start of or at the end of the completion percentage in the planning lines and ends at the specified end date.
- If the planning lines start after the Progress Line Date, then a vertical line is shown at the specified date, with no progress.
Lines with completed planning show no progress lines.

Baseline
If the Baseline checkbox is selected, the version comparison baseline lines are shown at the bottom of the planning lines. For more information, see Baseline.
Progress Completion Indicators
The % Complete from the planning processes is visualized in the process planning lines in two ways:
- Show the Progress column (only visible when manually shown via the Displays menu to choose visible columns icon below the chart)
- Color variation in the lines in which the darker color is the completed percentage (always visible)
The progress completion can be changed manually in the Progress column, which automatically updates the color variation in the lines.

Note
When the Sync "Realized %" to Process Lines field is enabled in Projects Setup, the % Complete values are automatically synchronized from the Realized % Finalized field in the Project Budget Line when a 1:1 relationship exists between the budget line and process line. For more information, see Realized Percent Synchronization.

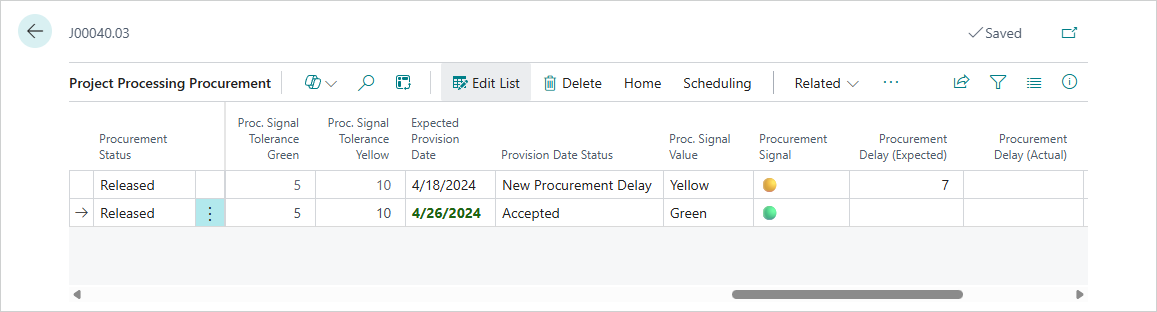

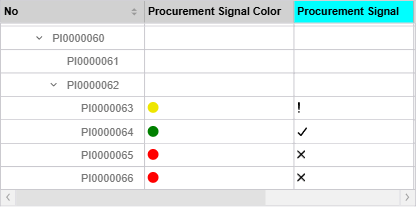

Procurement Signals
Procurement tracking provides transparency between project requirements and requirements fulfillment by calculating and displaying delayed procurement processes through a signal system. These procurement signals are visualized in the Procurement Signal Color and Procurement Signal columns (shown via the Displays menu to choose visible columns icon below the chart).
If a procurement signal is defined for the project in the Proc. Signal Code field on the Project Card, procurement signals are shown based on the procurement signal calculation for the project. The color in the Procurement Signal Color column and the symbol in the Procurement Signal column indicate the procurement signal status:
Green (✓): Procurement is on time or within the tolerated delay threshold defined in the Signal Tolerance Green field, or the delay has been accepted.
Yellow (!): Expected delay that exceeds the green tolerance but is within the Signal Tolerance Yellow field threshold (procurement finish date is in the future).
Red (x): Actual delay where the procurement finish date has passed and the requirement has not been fulfilled (posted quantity < quantity).

If there are several lines in the Project Processing Procurement page with different signal colors for a project planning line, the highest priority color is always displayed (red > yellow > green). For example, process line PI0000063 is showing a yellow signal. In its Project Processing Procurement page there are two procurement line: one is yellow and another is green; therefore, the project planning line will show yellow since it is more critical.

Project Schedule Lines
Project schedule lines are shown at the top of process lines to indicate when a resource is assigned. The color used is defined in the Project Schedule Color field in the Graphical Project Planning Setup page. Project schedule lines cannot be moved or edited.
Lead Time Process Lines
Process lines with Lead Time as the Process Channel can have a special color, defined in the Project Line Lead Time Color field in the Graphical Project Planning Setup page.
Context Menus
On both sides of the chart, context menus can be opened to provide additional information about the project or process planning line. Tap and hold (or right-click) the project or process planning line to open the context menu.
For detailed information about these menu items, see Project Planning and Resource Planning.
For the projects:
- The Project Card menu item opens the related Project Card.
- The Project Team menu item opens the related Project Team page.
- The Project Planning Setup menu item opens the Project Planning Setup page.
- The Project Planning and Processing menu item opens the Project Planning and Processing page that focuses on all operative processes for planning, purchasing, and project delivery.
- The Project Procurement Block View menu item opens the Project Processing Procurement page that shows the block view of procurement processes for the selected project planning line.
- The Mark menu item provides a visual indication of the selected project line by changing the color as well as adding a vertical line at the start and end of the line in the right pane. The color is based on the Highlight Color set in the Graphical Project Planning Setup page.
- If the project line is already marked, open the context menu again and choose the Unmark menu item to remove the visual indication.
- Only one line can be marked at a time. Unmarking another line will remove the vertical line from the previously marked line; however, the color change will remain until that line is unmarked specifically.
For the summary process lines:
- The Project Card menu item opens the Project Card of the project corresponding to the selected summary process line.
- The Process Card menu item opens the Project Process Card that provides a card view of all the information in the Project Planning and Processing page for the selected summary process line.
- The Process Planning Block View menu item opens the Planning Processes page that shows the block view of planning processes for the selected summary process line.
- The Procurement Block View menu item opens the Project Processing Procurement page that shows the block view of procurement processes for the selected summary process line.
- The Assigned Resources menu item opens the Project Process page that shows all resources assigned to the selected summary process line, and where resources can be added or removed.
- The Graphical Resource Planning menu item opens the Graphical Resource Planning page with planned and unplanned process lines expanded.
- Includes all projects within the same time frame, which have shared resources. This allows you to see the resource's available capacity among all their projects.
- Unplanned process lines are marked as orange in the right pane and shaded in the left pane to indicate what was selected in the Graphical Project Planning page. The shading on the left pane will differ depending on style/gantt settings. If a specific unplanned line is selected, only that line will be marked.
- The Graphical Resource Planning by Team menu item opens the Graphical Resource Planning by Team page with planned and unplanned process lines expanded.
- Includes all projects within the same time frame, which have shared resources. This allows you to see the resource's available capacity among all their projects.
- Unplanned process lines are marked as orange in the right pane and shaded in the left pane to indicate what was selected in the Graphical Project Planning page. The shading on the left pane will differ depending on style/gantt settings. If a specific unplanned line is selected, only that line will be marked.
- The Mark menu item provides a visual indication of the selected summary process line by changing the color as well as adding a vertical line at the start and end of the line in the right pane. The color is based on the Highlight Color set in the Graphical Project Planning Setup page.
- If the summary process line is already marked, open the context menu again and choose the Unmark menu item to remove the visual indication.
- Only one line can be marked at a time. Unmarking another line will remove the vertical line from the previously marked line; however, the color change will remain until that line is unmarked specifically.
For the project planning lines:
- The Project Card menu item opens the Project Card of the project corresponding to the selected project planning line.
- The Process Card menu item opens the Project Process Card that provides a card view of all the information in the Project Planning and Processing page for the selected project planning line.
- The Process Planning Block View menu item opens the Planning Processes page that shows the block view of planning processes for the selected project planning line.
- The Procurement Block View menu item opens the Project Processing Procurement page that shows the block view of procurement processes for the selected project planning line.
- For lines with assigned resources, the Project Schedule Entries menu item is available, which opens the Project Schedule Entries page that shows the scheduled project planning lines for the selected line. This menu item can also be accessed from the Project Schedule Line.
- The Assigned Resources menu item opens the Project Process page that shows all resources assigned to the selected project planning line, and where resources can be added or removed.
- The Project Schedule Entries menu item opens the Project Schedule Entries page that shows the scheduled project planning lines for the selected project planning line.
- The Graphical Resource Planning menu item opens the Graphical Resource Planning page focused on the selected project process lines.
- Includes all projects within the same time frame, which have shared resources. This allows you to see the resource's available capacity among all their projects.
- For unplanned process lines, all process lines are expanded.
- For assigned process lines, process lines are expanded to the assigned resource(s).
- The selected process line is shown in orange in the right pane and shaded in the left pane to mark which process line(s) opened the Graphical Project Planning page. The shading on the left pane will differ depending on style/gantt settings. If the process line is assigned to multiple resources, it will be marked for all lines.
- The Graphical Resource Planning by Team menu item opens the Graphical Resource Planning by Team page focused on the selected project process lines.
- Includes all projects within the same time frame, which have shared resources. This allows you to see the resource's available capacity among all their projects.
- For unplanned process lines, all process lines are expanded.
- For assigned process lines, process lines are expanded to the assigned resource(s).
- The selected process line is shown in orange in the right pane and shaded in the left pane to mark which process line(s) opened the Graphical Project Planning page. The shading on the left pane will differ depending on style/gantt settings. If the process line is assigned to multiple resources, it will be marked for all lines.
- The Mark menu item provides a visual indication of the selected project planning line by changing the color as well as adding a vertical line at the start and end of the line in the right pane. The color is based on the Highlight Color set in the Graphical Project Planning Setup page.
- If the project planning line is already marked, open the context menu again and choose the Unmark menu item to remove the visual indication.
- Only one line can be marked at a time. Unmarking another line will remove the vertical line from the previously marked line; however, the color change will remain until that line is unmarked specifically.
For the dependencies:
- In the right pane, lines connecting the planning lines indicate dependencies. In the context menu:
- Choose the Delete Dependency menu item to delete dependencies as needed.
- Choose the Project Line Planning Predecessors menu item to open a list of all predecessors of the project planning line.
- In the right pane, lines connecting the planning lines indicate dependencies. In the context menu:
Grouping
In the Graphical Project Planning Setup page, a default setting can be made to open the Graphical Project Planning page with project lines grouped by the No., Description, Person Responsible, Process ID, or Process Outline No. column. These columns have ascending/descending arrows for project sorting, which can be adjusted by adding the columns to the page via the Displays menu to choose visible columns icon at the bottom of the page.
Tooltips
The right-pane includes tooltips for the project and process lines:
- Project line tooltips show the related project number, status, project description, start/end date/time, and completion percent of the process line.
- Summary process line tooltips show the related project number, status, process description, process number, start/end date/time, completion percent of the process line, and assigned resource(s).
- Project planning line tooltips show the related project number, status, start/end date/time, completion percent of the process line, duration (e.g., 2 weeks), and assigned resource(s).
- Scheduled planning process line tooltips show the related project number, status, process description, process number, start/end date/time, completion percent of the process line, duration (e.g., 2 Weeks), and assigned resource(s).
- Baseline line tooltips show the related project number, status, process description, process number, and baseline version, start, and end date.
To view a tooltip, tap (or hover over) an entry.
While moving planning lines, a tooltip shows the new start and end days/dates of the potential change.
Usage
The Graphical Project Planning page provides a wide-range of information about project planning. It can be used as a general overview but also allows you to move planning lines to different times as well as add or remove dependencies. When these changes are made, the project planning logic updates the planning lines in COSMO Project Manufacturing.
To move planning lines
Planning lines can only be moved horizontally within the entry. You cannot move a planning line to another area in planning.
- To move an entire line to another date, tap and hold (or click) the line and move it forward or backward to a new date.
- To move a start or finish date of a planning line, tap and hold (or click) the start or end of the line and extend or shorten the time frame.
- Duration Quantity, Duration Format, Work Quantity, Work Format, and Planned Capacity % of the planning processes are updated in the Graphical Project Planning page based on the standard COSMO Project Manufacturing calculations, which considers the time frame and capacity changes.
- If the start or finish date of a planning line is extended/shortened in the right pane, and the Process Type Fixed field is:
- Work, then the Planned Capacity %, Duration Quantity, and Start and/or Finish dates are changed in the process line as well as in the left pane (if shown via the Displays menu to choose visible columns icon).
- Duration, then the Work Quantity and Duration Quantity are changed in the process line as well as in the left pane (if shown via the Displays menu to choose visible columns icon).
To adjust planning lines using columns
The Work Quantity, Work Format, Duration Quantity, Duration Format, Process Type Fixed, and Planned Capacity columns can be shown in the Graphical Project Planning page (added via the Displays menu to choose visible columns icon at the bottom of the chart).
- Changes made in the Work Quantity column will extend/shorten the time frame in the right pane as well as update the Duration Quantity and other relevant parameters in the process line if the Process Type Fixed field is Work. If the Process Type Fixed field is Duration, the Planned Capacity % is changed.
- Changes made in the Duration Quantity column will extend/shorten the time frame in the right pane as well as update the Planned Capacity % and other relevant parameters in the process line if the Process Type Fixed field is Work. If the Process Type Fixed field is Duration, the Work Quantity is changed.
- Changes made in the Planned Capacity column will extend/shorten the time frame in the right pane as well as update the Duration Quantity and other relevant parameters in the process line if the Process Type Fixed field is Work. If the Process Type Fixed field is Duration, the Work Quantity is changed.
- Changes made to the format (hours, days, etc.) can be done directly in the Work Format and Duration Format columns to update the planning line.
To add or delete dependencies
Dependencies are the vertical lines connecting the planning lines.
- To add a dependency, tap and hold (or click) the process line and then move to another process line. A new will show the connection between the lines.
- To delete a dependency, tap and hold (or click) a dependency line and then choose Delete Dependency.
Feedback
